An overview of progress on the Grantham Southern Relief Road project.
What we achieved in September
West side of site
- Continued assembly of access gantry

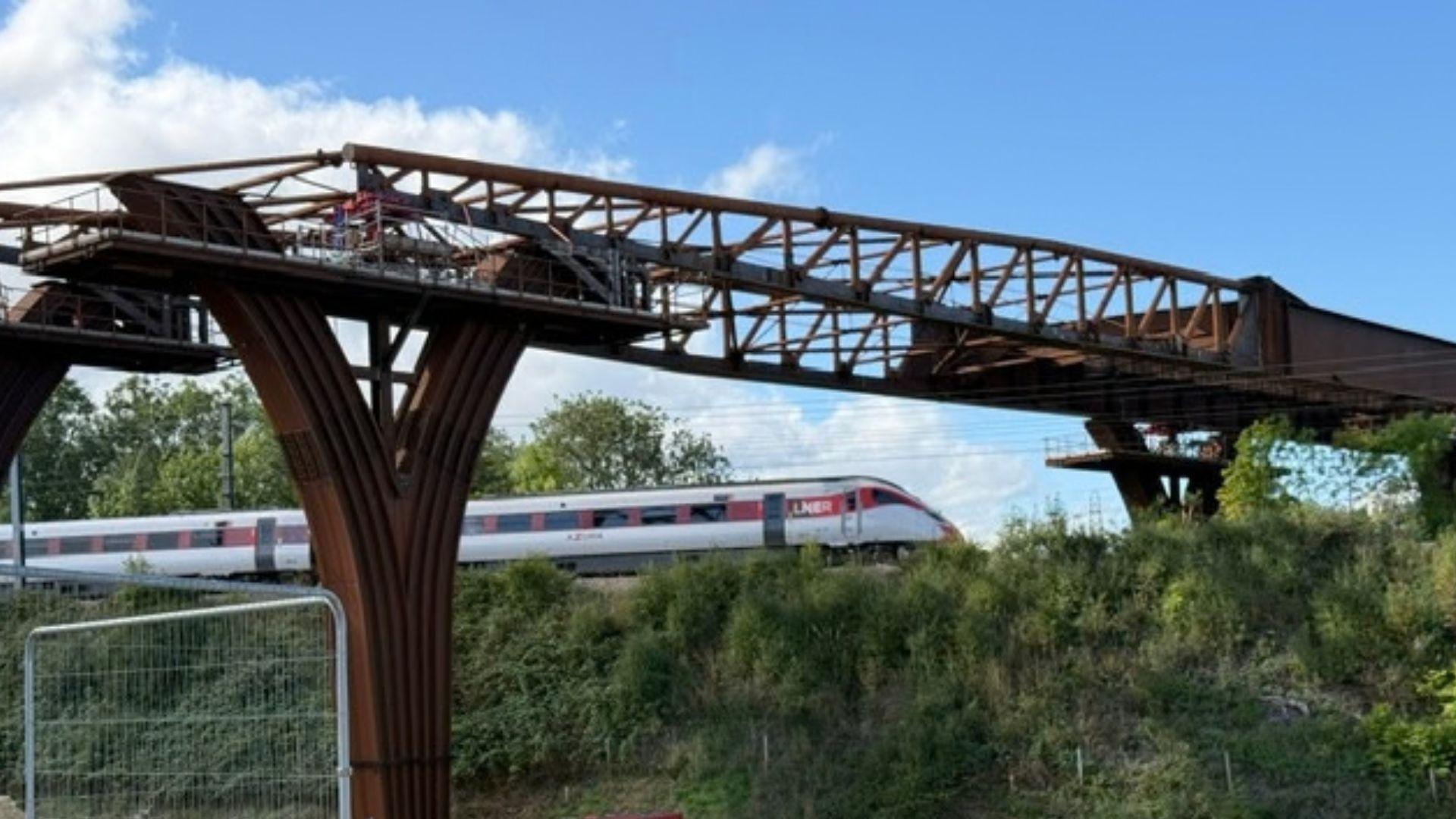

- Carried out Shunt 3 from pier 3 to pier 4, which was roughly 70m
- Continued removal of launch equipment in launch area
East side of site
- Removal of temporary work supports at pier 4 under night-time works
- Installation of temporary works to Pier 5
What's happening in October
West side of site
- Complete assembly of access gantry
- Continue removal of launch equipment in launch area
East side of site
- Continue shunt 3 across East Coast Mainline through to Pier 5 under night-time works
- Commence removal of bridge launch nose
- Launch temporary works to Pier 5
- Begin removal of Span 5 temporary plates
Current/ongoing traffic restrictions and closures
- Lane restrictions around the B1174 Roundabout to facilitate the construction of the haul route and access into site
Upcoming traffic restrictions and closures
- N/A
